News

May 2026 Update

May 19, 2026

For the last few weeks we have been cleaning, preparing and pulling pipes throughthe existing box culvert.

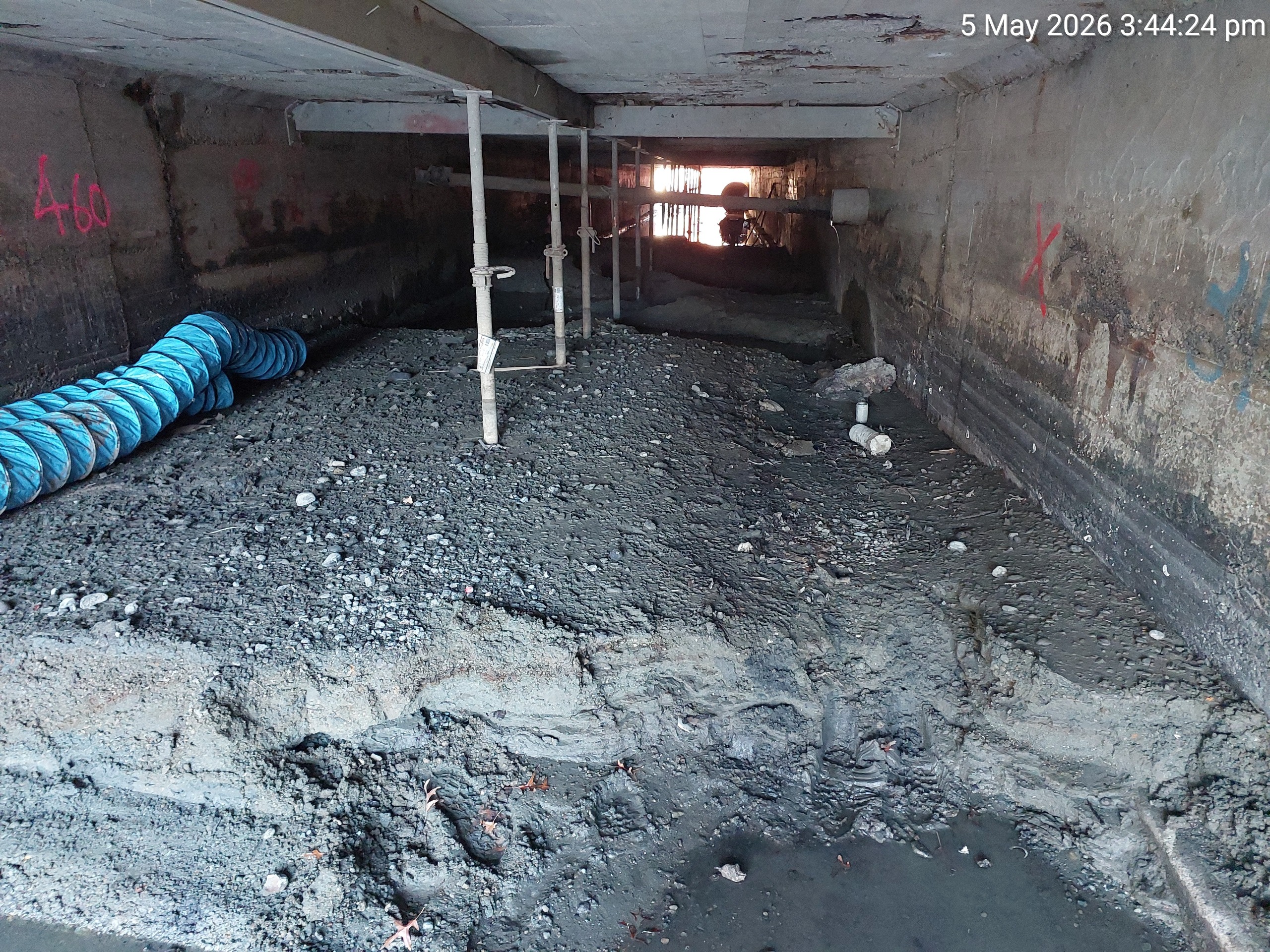

  • We have removed over 100 cubic meters of silt and debris that has built up over the lifespan of the culvert (up to 520mm thick).
  • We replaced the props supporting the current ceiling of the culvert.

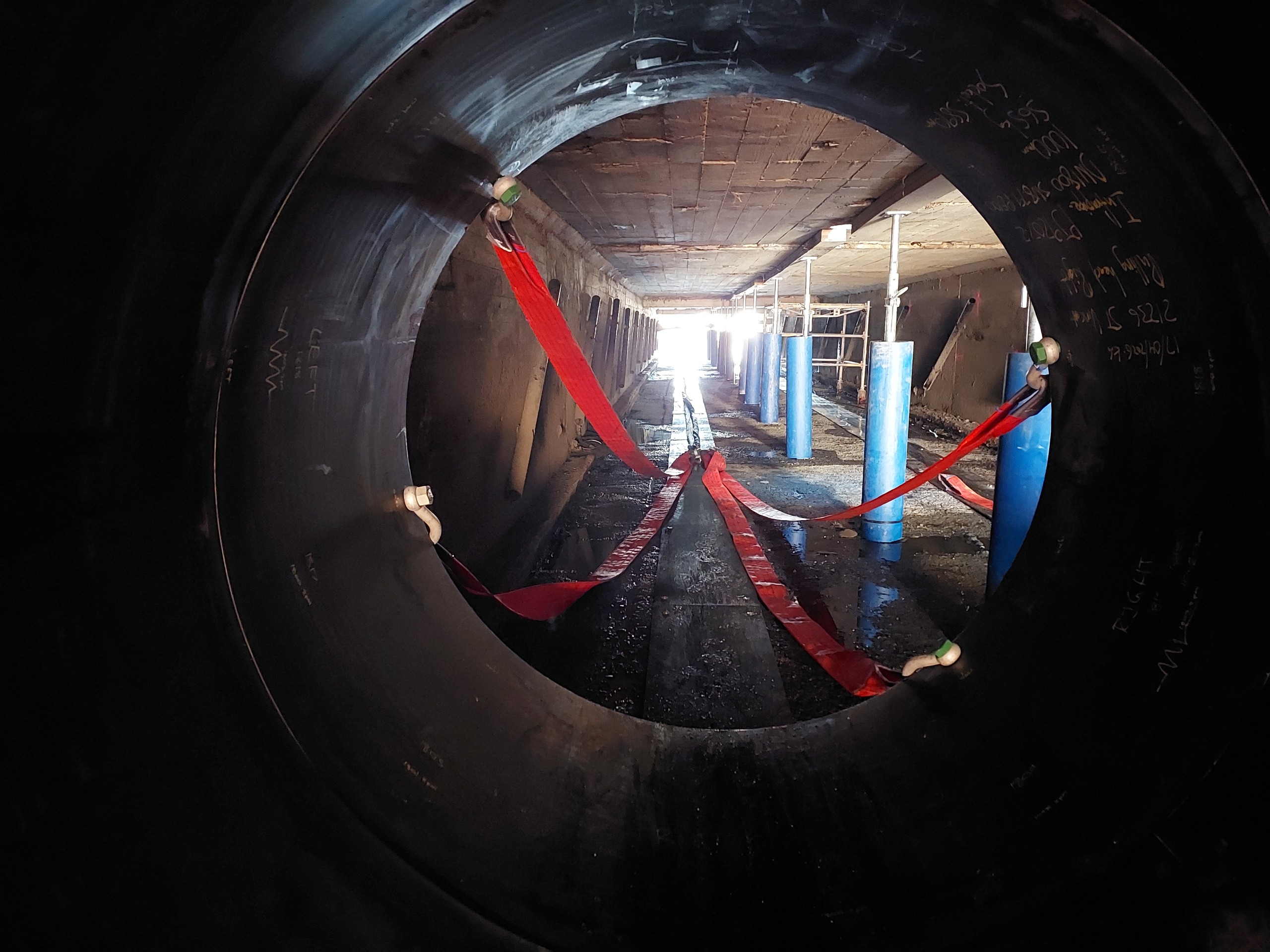

  • We installed pipe runners on the walls and around the central props to guide the pipes during the winching.
  • We have welded and pulled 8 total pipes through the culvert with 10 pipes left to pull through.
